A Quoted Megawatt Is Not A Deployment Date: A Utility-First Site Selection Checklist For Malaysia

Blog, Article

A quoted megawatt is an ambition, not an operational schedule. Until a power sub-station is energised, cooling circuits are charged, and dark fibre is spliced, capacity exists purely as a balance-sheet asset. For infrastructure directors evaluating a data centre site selection Malaysia strategy, capital allocation decisions must pivot away from speculative land announcements towards verifiable execution evidence.  […]

A Quoted Megawatt Is Not A Deployment Date: A Utility-First Site Selection Checklist For Malaysia

A quoted megawatt is an ambition, not an operational schedule. Until a power sub-station is energised, cooling circuits are charged, and dark fibre is spliced, capacity exists purely as a balance-sheet asset. For infrastructure directors evaluating a data centre site selection Malaysia strategy, capital allocation decisions must pivot away from speculative land announcements towards verifiable execution evidence.

Malaysia’s digital infrastructure market is maturing rapidly. Under the Malaysian Investment Development Authority’s (MIDA) Digital Ecosystem Acceleration (DESAC) framework, tax incentives and operational concessions are tied directly to audited Power Usage Effectiveness (PUE) and Water Usage Effectiveness (WUE) metrics. Capital efficiency now depends entirely on securing a utility-ready data centre with binding delivery schedules.

To insulate compute deployments from schedule slippage, retrofits, and stranded hardware, infrastructure leads must apply a seven-gate data centre site selection checklist prior to contract execution.



1. Workload Specification & Density Profiling

High-density AI and machine learning clusters operating at 30kW to 150kW+ per rack exceed the thermal capacity of legacy air-cooled facilities.

  • Strategic Risk: Thermal bottlenecks, constrained floor space, or unplanned capital expenditure for liquid-cooling retrofits.
  • Required Evidence: Floor weight-bearing certifications (≥15–20 kN/m2≥15–20 kN/m2) dual-path power distribution schematics, and pre-engineered containment pathways.

2. Deliverable Power & Time To Power Malaysia

Capacity reservations on marketing literature do not equal energised high-voltage transformers on-site. Securing predictable time to power Malaysia commitments requires auditing the operator’s grid interconnection status.

  • Strategic Risk: Revenue delays spanning years while awaiting utility sub-station construction or high-voltage line laying.
  • Required Evidence: Executed Tenaga Nasional Berhad (TNB) supply contracts, sub-station commissioning schedules, and binding phased energisation milestones.
  • Facility Proof Point: Open DC’s D8-1 facility in the Delapan Special Border Economic Zone (SBEZ), Kedah demonstrates an executed model of phased power deliverability, scaling systematically from an initial 5MW allocation to a 20MW total footprint.

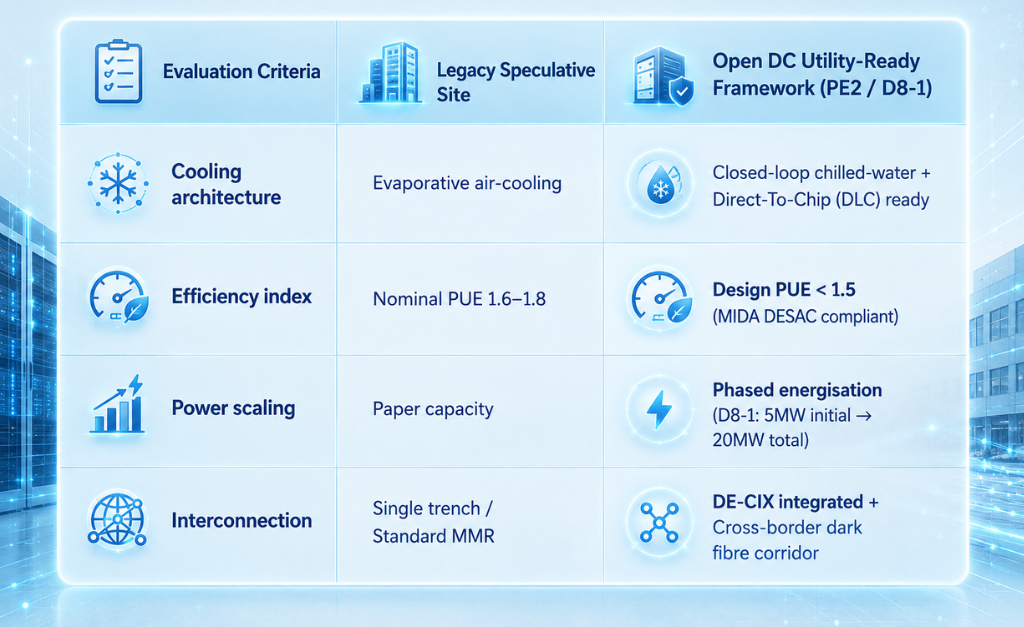

3. Cooling Efficiency & Environmental Resource Management

Sustainable data centre power and cooling models must comply with national water conservation benchmarks (WUE≤2.2 m3/MWhWUE≤2.2 m3/MWh).

  • Strategic Risk: Forfeiture of MIDA DESAC tax incentives and exposure to local municipal water restrictions.
  • Required Evidence: Closed-loop chilled-water system engineering, direct-to-chip liquid cooling (DLC) readiness, and verified PUE simulation models targeting under 1.5.
  • Facility Proof Point: Open DC’s PE2 facility in Penang utilises advanced chilled-water infrastructure with customisation options for direct-to-chip cooling, engineered to achieve a design PUE under 1.5 while drastically reducing municipal water dependency.



4. Mechanical, Electrical & Spatial Engineering

High-density deployments require specific physical adaptations beyond raw power capacity.

  • Strategic Risk: Physical inability to install Coolant Distribution Units (CDUs) or heavy liquid-cooled racks due to ceiling height or loading caps.
  • Required Evidence: Slab-to-slab clear heights, dedicated CDU pipe containment pathways, and pre-engineered liquid cooling interfaces.



5. Physically Diverse Connectivity & Network Readiness

True redundancy demands distinct physical conduit pathways, conduit isolation, and carrier neutrality rather than dual fibre feeds sharing a single utility trench.

  • Strategic Risk: Single-point-of-failure exposure across municipal duct pathways resulting in network outages.
  • Required Evidence: GIS pathway mapping of underground fibre ingress routes, dual Meet-Me-Rooms, and direct access to neutral Internet Exchange platforms.
  • Interconnection Proof Point: PE2 and D8-1 deliver immediate carrier-neutral peering integrated with DE-CIX Malaysia. D8-1 further extends regional resilience via direct cross-border dark fibre routes connecting Malaysia and Thailand, bypassing congested metro transmission paths.



6. Regulatory Compliance & Sustainability Evidence

Commercial deployment timelines rely on existing municipal clearances and operational accreditations.

  • Strategic Risk: Deferred go-live dates driven by pending local authority permits or non-compliance with regional data governance rules.
  • Required Evidence: TIA-942 Rated 3 certification, ISO 27001, PCI-DSS compliance, and formal DESAC incentive qualification documentation.



7. Operational Scalability & Expansion Rights

Site selection decisions must account for long-term operational continuity and contiguous growth options.

  • Strategic Risk: Fragmentation of compute nodes across disparate facilities when scaling beyond initial footprint limits.
  • Required Evidence: Site development master plans detailing adjacent land rights, modular power expansion options, and binding technical SLAs.

As detailed in Why Data Centre Location Matters in the AI Era, evaluating digital infrastructure must evolve beyond municipal postcodes towards local grid strength, energy stability, and international connectivity corridors.

Before committing capital to unverified timelines, demand execution proof. Share your IT load parameters, rack density requirements, and go-live schedules with Open DC’s engineering team to benchmark your deployment against our utility-ready footprint and DE-CIX interconnection ecosystem.



Empowering Southeast Asia’s Digital Future.



For further enquiries

☎️:  03 8888 8188 (General Line)
📱: 012 3188 0446 (Sales)

📧: enquiry@opendc.my

Operating Hours: Monday – Friday, 9am – 6pm

Share this on:

Related Blog, Article

The Illusion Of Independence: Why Capacity Without Redundancy Endangers Malaysia’s Digital Future
9 September 2026

The Illusion Of Independence: Why Capacity Without Redundancy Endangers Malaysia...

Two Sites Are Not Two Paths: Building Resilience Across The Malaysia-Singapore Interconnection Corridor
4 September 2026

Two Sites Are Not Two Paths: Building Resilience Across The Malaysia-Singapore I...

Can Bukit Kayu Hitam Become Malaysia’s Tech Hub?
3 September 2026

Can Bukit Kayu Hitam Become Malaysia’s Tech Hub?

Get in touch with us

We are always ready to help you answer your question

Call & Chat
Operating hours: 9am to 6pm. Mondays to Fridays
Headquarters
34B, Jalan Diplomatik 3/1, Presint 15, ​ ​62050 Putrajaya, ​ ​
Wilayah Persekutuan Putrajaya, ​ ​
Malaysia.
The information contained on this website is for general information purposes only. The information is provided by Open DC Sdn Bhd (1138988-T) and while we endeavour to keep the information up to date and correct as much as possible. When you visit or interact with our sites, services, applications, tools or messaging, we or our authorised service providers may use cookies, web beacons, and other similar technologies for storing information to help provide you with a better, faster and safer experience and for advertising purposes.
Copyright © Open DC Sdn Bhd (1138988-T) | All Rights Reserved. [F]

Download A Quoted Megawatt Is Not A Deployment Date: A Utility-First Site Selection Checklist For Malaysia Brochure

Please fill in your details to download.
Download Brochure
Open DC Sdn Bhd
Data Centres
Central
Cyberjaya
Northern
Penang
Kedah
Southern
Johor Bahru

Copyright © Open DC Sdn Bhd (1138988-T) | All Rights Reserved.
